Concepts: Alternate Lifecycle Patterns
Topics

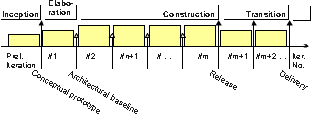

"The incremental strategy determines user needs, and defines the system
requirements, and then performs the rest of the development in a sequence of builds. The
first build incorporates parts of the planned capabilities, the next build adds more
capabilities, and so on until the system is complete." [DOD94]
The following iterations are characteristic:
- a short Inception iteration to establish scope and vision, and to define the business
case
- a single Elaboration iteration, during which requirements are defined, and the
architecture established
- several Construction iterations during which the use cases are realized and the
architecture fleshed-out
- several Transition iterations to migrate the product into the user community

This strategy is appropriate when:
- The problem domain is familiar
- Risks are well-understood
- The project team is experienced

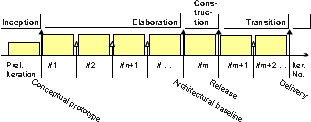

"The evolutionary strategy differs from the incremental in acknowledging that user
needs are not fully understood, and all requirements cannot be defined up front, they are
refined in each successive build." [DOD94]
The following iterations are characteristic:
- a short Inception iteration to establish scope and vision, and to define the business
case
- several Elaboration iterations, during which requirements are refined at each iteration
- a single Construction iteration, during which the use cases are realized and the
architecture fleshed-out
- several Transition iterations to migrate the product into the user community

This strategy is appropriate when:
- The problem domain is new or unfamiliar
- The team is inexperienced

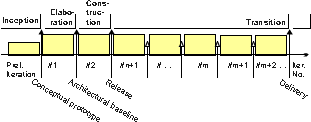

Some authors have also phased deliveries of incremental functionality to the customer [GIL88]. This may be required where there are
tight time-to-market pressures, where delivery of certain key features early can yield
significant business benefits.
In terms of the phase-iteration approach, the transition phase begins early on and has
the most iterations. This strategy requires a very stable architecture, which is hard to
achieve in an initial development cycle, for an "unprecedented" system.
The following iterations are characteristic:
- a short Inception iteration to establish scope and vision, and to define the business
case
- a single Elaboration iteration, during which a stable architecture is baselined
- a single Construction iteration, during which the use cases are realized and the
architecture fleshed-out
- several Transition iterations to migrate the product into the user community

This strategy is appropriate when:
- The problem domain is familiar
- the architecture and requirements can be stabilized early in the development cycle
- there is a low degree of novelty in the problem
- The team is experienced
- Incremental releases of functionality have high value to the customer

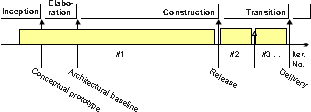

The traditional waterfall approach can be seen as a degenerated case in which there is
only one iteration in the construction phase. It is called "grand design" in [DOD94]. In practice, it is hard to avoid additional
iterations in the transition phase.
The following iterations are characteristic:
- a short Inception iteration to establish scope and vision, and to define the business
case
- a single very long Construction iteration, during which the use cases are realized and
the architecture fleshed-out
- several Transition iterations to migrate the product into the user community

This strategy is appropriate when:
- a small increment of well-defined functionality is being added to a very stable product
- the new functionality is well-defined and well-understood
- The team is experienced, both in the problem domain and with the existing product
In practice few projects strictly follow one strategy. You often end up with a hybrid,
some evolution at the beginning, some incremental building, and multiple
deliveries. Among the advantages of the phase-iteration model is that it lets you
accommodate a hybrid approach, simply by increasing the length and number of iterations in
particular phases:
- For complex or unfamiliar problem domains, where there is a high degree of exploration:
increase the number of iterations in the elaboration phase and its length.
- For more complex development problems, where there is complexity translating the design
into code: increase the number of iterations in the construction phase and its length.
- To deliver software in a series of incremental releases: increase the number of
iterations in the transition phase and its length.
| |

|
